# Graphs build Dynamic Agent Orgs
**作者**: Shubham Saboo
**日期**: 2026-08-04T03:01:56.000Z
**来源**: [https://x.com/Saboo_Shubham_/status/2084474890812338252](https://x.com/Saboo_Shubham_/status/2084474890812338252)
---

Loops made agent behavior programmable. Graphs make agent orgs programmable.
And a dynamic agent org is where the graph rewrites itself while the work is happening.
Here's what that looks like in my own setup: six agents, a shared state layer they all read from, and a coordinator that restructures the team based on what comes back.

A loop is how one agent works. A graph is how the work connects.
Everything else here is that one sentence with the details filled in.
## Why "graph" confuses everyone

Peter Steinberger asked a few weeks ago whether we're still talking loops or shifted to graphs yet. The replies went in five directions at once, which tells you the word isn't doing its job.
A graph is just things and how they relate to each other. Which task blocks which. Which one belongs to which. What has to finish before the next thing starts.
That's not the confusing part. The confusing part is whether the graph holds still.
Most workflow graphs don't move. You lay out the boxes and arrows before anything runs, and that's the shape you get. This is the flowchart most people picture when they hear the word.
A dynamic graph changes while it's running. Think of a social network. People add friends and drop them. Groups form and fall apart. New people show up, others leave. The relationships are the whole point, and not one of them holds still.
Task graphs work the same way. An agent finds work nobody planned for and adds it. Something gets unblocked. A task finishes and drops off the board.
So the real question isn't "are we doing graphs." It's whether yours can change while the work is happening.

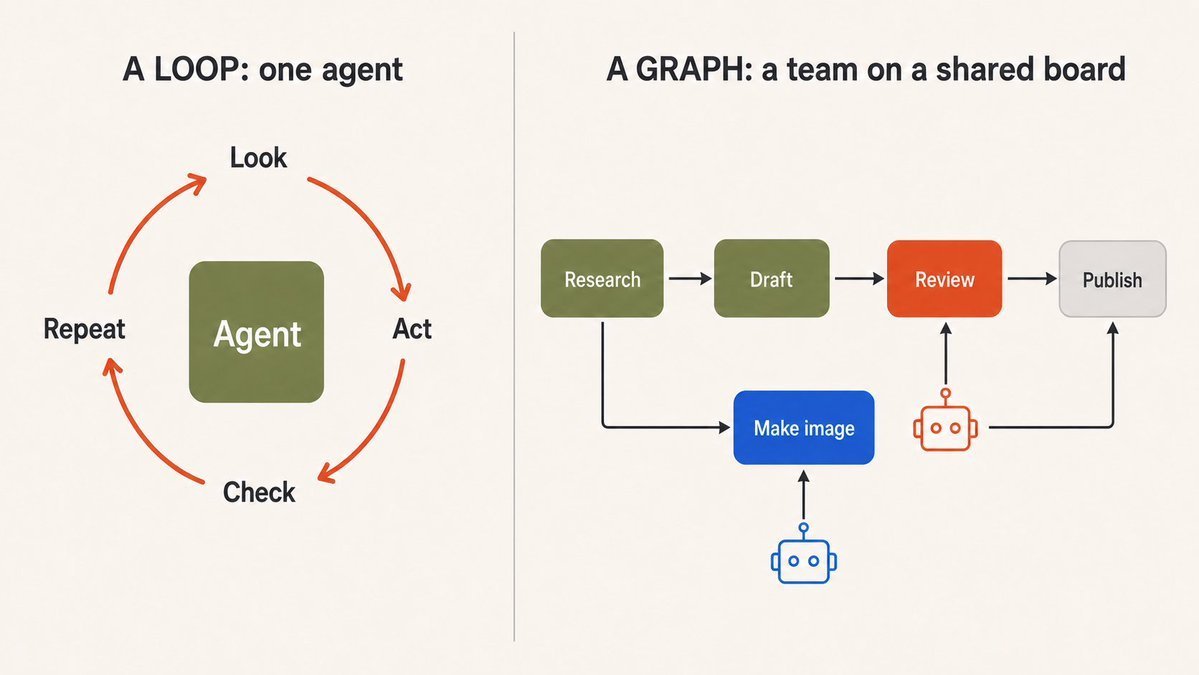

## A loop: one agent, one mental checklist
Start with the simplest thing. A loop is a single agent working by itself. It looks at the situation, does one thing, checks the result, then decides what to do next. Round and round until the job is done.
look → do a thing → check result → repeat or stop
A loop works because the agent doesn't need the whole plan up front. It figures out the next step from what just happened.
For one agent doing one clear job, a loop is all you need. Give it a goal, some tools, and a way to check its own work. Don't build a tiny org chart around a task one agent could finish in three steps.
A loop starts to strain when the job is too big for one agent to hold in its head, or when you have several agents and the work has to survive one of them stopping and another picking it up. Nobody has the full picture. Things fall through the cracks.
That's when the plan needs to leave everyone's head and go somewhere shared.
## A graph: the plan lives on a board, not in agent's head

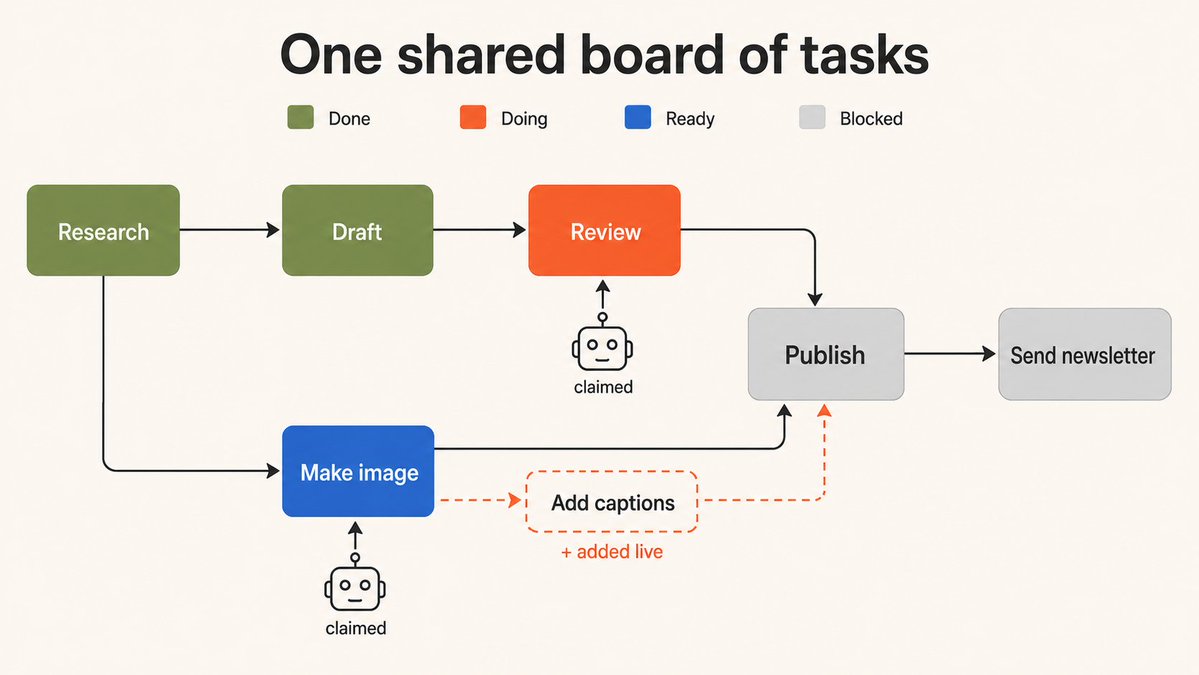

Picture a wall of sticky notes. Each note is a task. An arrow from one note to another means "this one has to finish before that one can start." Any agent can walk up, take a note that's ready, do the work, and move it to done.
That's a graph. And the jargon maps to plain things:
- A node is a sticky note. One task.
- An edge is an arrow between notes. It's the relationship: blocks, belongs to, comes first.
- State is what's written on each note right now (ready, in progress, done).
- Claiming a task is an agent putting its name on a note so two agents don't grab the same one.

The board is what makes many agents possible. The plan survives any single agent finishing, because nobody has to hold it in their head. It's written down where everyone can see it.
This isn't a new shape. It's a DAG with a work queue on top, the thing build systems and job schedulers have run on for decades. The new part is pointing agents at it instead of humans or CI jobs.

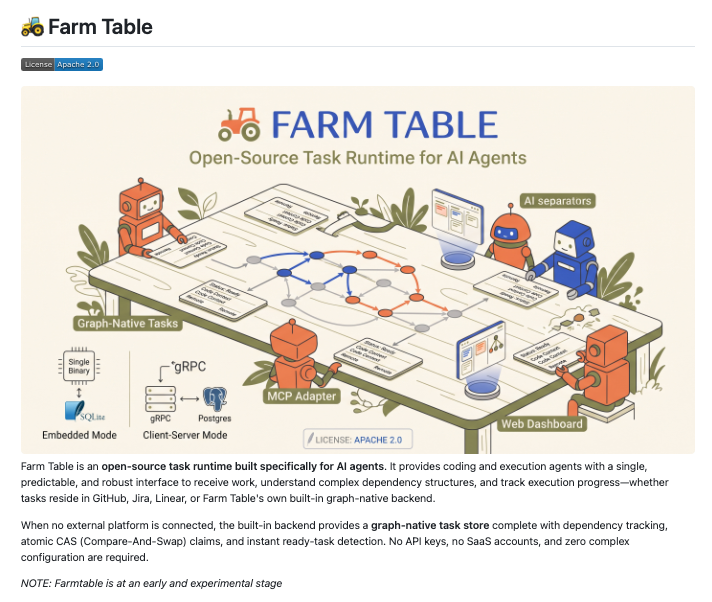

One project doing exactly that is FarmTable, built by my friend Preston (@ptone). Instead of cramming a plan into one agent's prompt, you put the tasks on a shared board that every agent can read and write. Agents walk up, grab a task that's ready, do it, and mark it done.
FarmTable tracks which tasks are ready, which are blocked, what depends on what, and who's working on which. Two agents can't grab the same note, because claiming a task is atomic. And an agent can add a brand-new note mid-run when it discovers work nobody planned for.

Ready work also sets your ceiling. You can't run five agents when only two tasks are unblocked. The board tells you how many agents the work can actually absorb.
The plan is shared state, not a doc everyone quietly stops following.
This is where it splits from most graph-based agent frameworks. There you lay out the steps in advance, and the boxes are functions. Here the boxes are tasks, and the agents add them as the work reveals itself. The two can live together: one runs a single agent's internal steps, the other coordinates many agents on top.
## The board changes while the work happens
Most new work comes from doing the work. You're building a feature and you spot a bug. The instinct is to either stop and fix it, which derails you, or make a mental note, which means losing it. On a board, the agent that finds it writes it down as a new task and keeps going. Work gets captured by whoever discovers it, at the moment they discover it.
Once the plan is data on a board, the same thing happens to the team. Not just the tasks. The org itself.

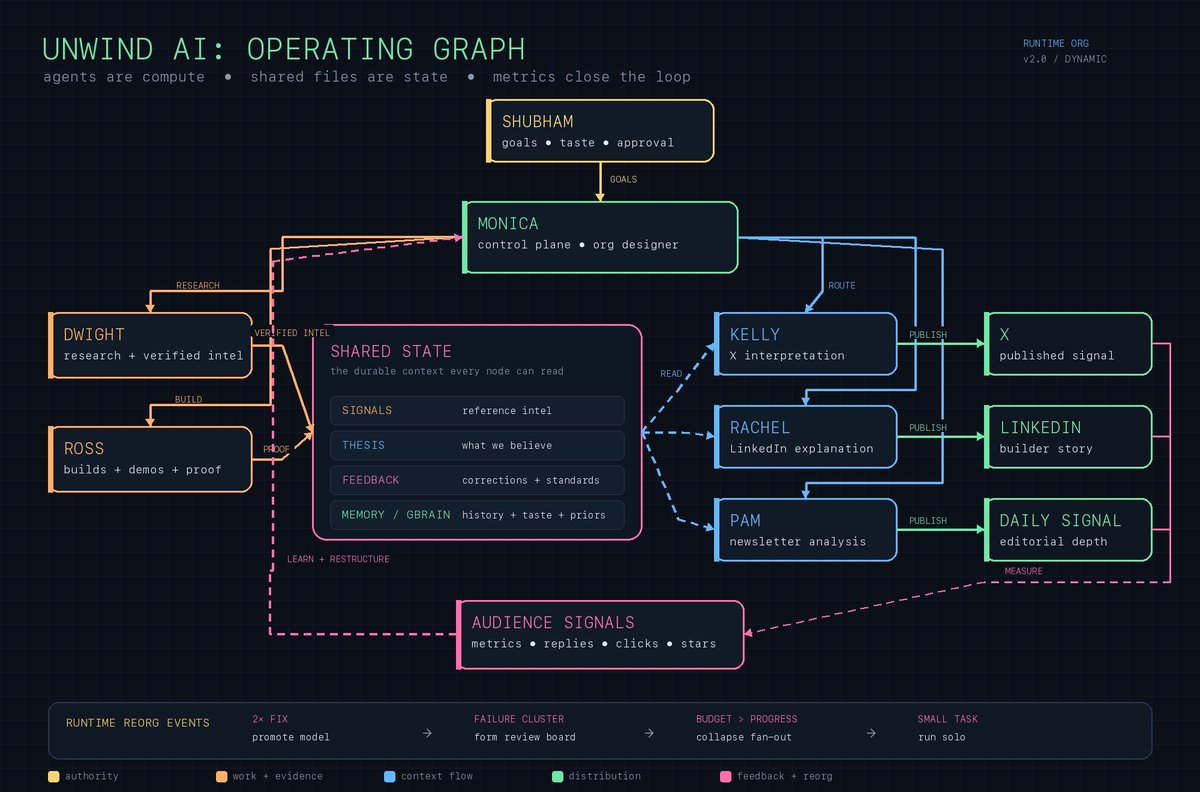

I run six agents around the clock for research, engineering, and content. A coordinator sits on top and watches how the work is going. When the signals change, it restructures the team. A few concrete rules:

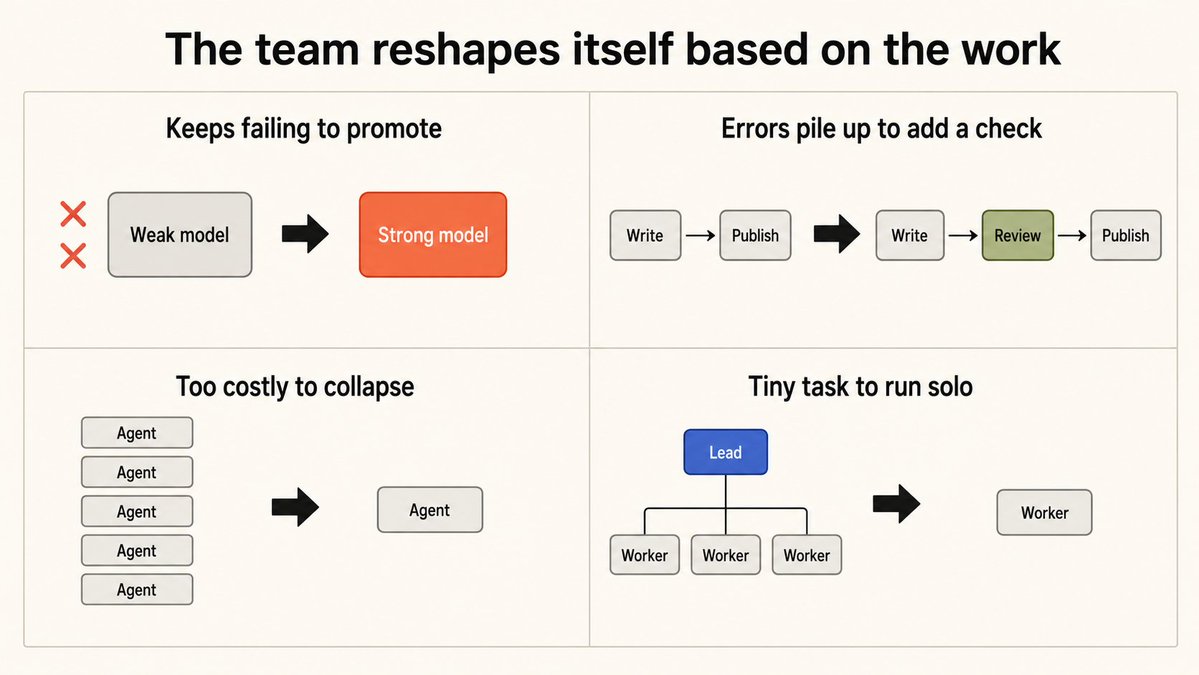

- Same mistake twice, switch to a stronger model. If an agent needs correcting on the same kind of task twice, that work automatically routes to a better model.
- Errors piling up in one area, add a reviewer. A temporary checking step appears between "done" and "published." When quality settles, it disappears.
- Burning more money than the work is worth, collapse the team. If five agents running in parallel cost more than the job justifies, it drops back to one strong agent doing it solo.
- Tiny task, skip the whole thing. A one-line fix doesn't need an org. One agent handles it.
The extra structure only exists while the work needs it. When the work settles, the structure dissolves.
The org chart stopped being a setting you configure. It's something the system edits while it runs. This is what "dynamic" actually means. Not an agent picking between two branches someone wrote in advance. The team visibly changes because the work changed.

## Three ways a board drifts from reality
A board is only useful if it matches the real world. When it doesn't, agents work hard on the wrong things and report success that isn't real. Preston's run hit all three of the ways this happens, and any agent system on a shared plan will hit them too.
1. A tidy board can still be out of date. Those 57 tasks looked perfect. The planner never checked the code, so a third were already done. Read reality before you build the plan.

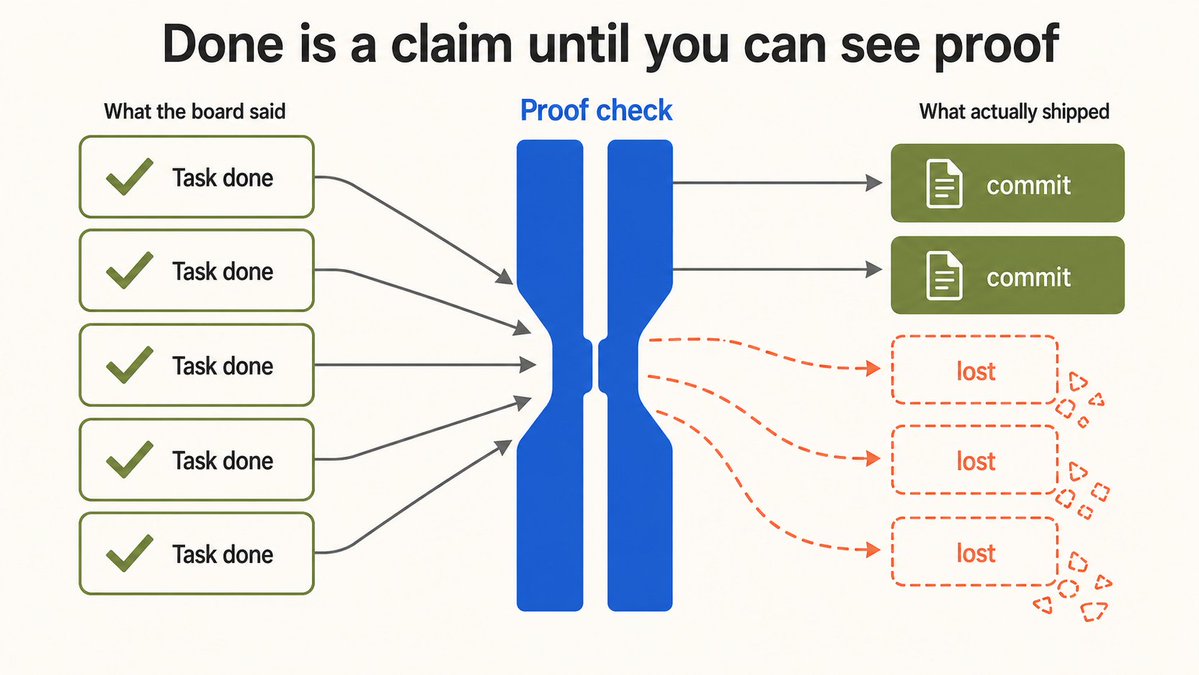

2. "Done" is a claim until you see proof. Five marked done, two actually shipped. Marking a task done is just editing a row in a database, it doesn't make the code exist. Re-run the tests instead of trusting the status. And check the tests actually cover what was supposed to be built.
3. Bookkeeping can't live in the agent's memory. One agent fixed a bug but skipped claiming the task, so nothing recorded who did it. Claiming is what stops two agents grabbing the same work. The board should record it automatically, or it will drift.
All three come down to one rule: trust the board only as far as it's tied to something real.

## When you don't need any of this
- Use a loop when one agent can hold the whole job in its head, use its tools, and check its own work.
- Use a fixed flowchart (like LangGraph) when the steps are stable and you want them predictable.
- Use a shared board when the work branches, when finishing one task creates or cancels others, when different tasks need different skill levels, when "done" needs real proof, and when the team should grow or shrink as it goes.
Use the smallest thing that keeps the mess manageable.
Before you reach for a graph, answer three questions:
1. What does each task produce?
2. What does each arrow mean?
3. What proof lets the next task start?
If one agent can hold it all, keep the loop. If the work has to survive handoffs and change shape as you learn, put it on a board. Then let the agents loop away inside it.
Loops made agent behavior programmable. Graphs make agent orgs programmable. And the interesting part is what happens next, when the team stops being something you wire up in advance and starts shaping itself around the work.
